Project Information
Miner Road Workplan and schedule
Construction of the pipeline in Miner Road will begin in late May 2023 and will continue through the fall of 2023. Work hours will be 8 a.m. to 8 p.m. during the Orinda schools summer session to maximize work progress during this time period.
Open trench construction will occur along Miner Road to install the pipeline. There is not sufficient room to keep a lane open to vehicles through the work area. Miner Road will be closed to through traffic and a detour will be established. Access to residences in the work area/closure zone will be accommodated but may incur some delays. The pipeline installation work will proceed from Lombardy Lane towards Tiger Tail Ct. Miner Road will be re-paved by the City of Orinda following completion of the EBMUD pipeline work.
The proposed project timeline is below, please note as with all construction projects, these dates are tentative and subject to change.
Stage 1 timeline: May 30 to June 12
Stage 2 timeline: June 5 to June 30
Stage 3 timeline: June 26 to August 8

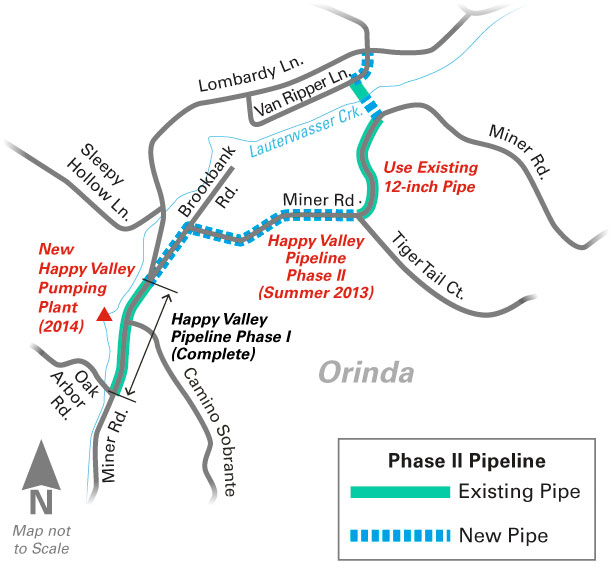

Throughout the project, construction signage will be regularly updated to provide directions for residents and drivers regarding which route to take. It is important to note that no two sections of the staged area on the map will be closed simultaneously. Please review the three stages of the project on the map below. While there is no planned overlap of active construction during the project, contractors may need to move equipment between locations during different stages of the project.
The City of Orinda has committed to fully repave Miner Rd. at the conclusion of the project.
Traffic Detour
In close coordination with the City of Orinda and with approval from the Orinda City Council, EBMUD will implement the following traffic detour route. We are asking anyone who does not live on Miner Road to avoid the area as EBMUD crews perform this important work.
Contact information
Joe Voelker, Community Affairs Representative
Email: construction-east@ebmud.com
Phone: 510-287-2053
For after-hours, call EBMUD at 866-403-2683.
Published studies and other resources
The Happy Valley Pumping Plant and Pipeline Project is an element of the Water Treatment and Transmission Program. The EIR for the WTTIP was certified by the EBMUD Board of Directors in December 2006. The draft Supplemental Environmental Impact Report (SEIR) is available below.
Traffic Detour Map
The proposed project timeline is below, please note as with all construction projects, these dates are tentative and subject to change.
Stage 1 timeline: May 30 to June 12
Stage 2 timeline: June 5 to June 30
Stage 3 timeline: June 26 to August 8
